A high mast lighting specification should define the mast, headframe or lowering assembly, attached equipment, base connection, protective finish and required documents. Set these against the site and lighting layout before comparing suppliers. Height, wall thickness, luminaire quantity and lowering capacity must be confirmed for the proposed configuration.
Use this guide to organize a high mast lighting design review and supplier RFQ. It is an input checklist, not a substitute for the project’s lighting calculation, structural design, local code review, or approved drawings.

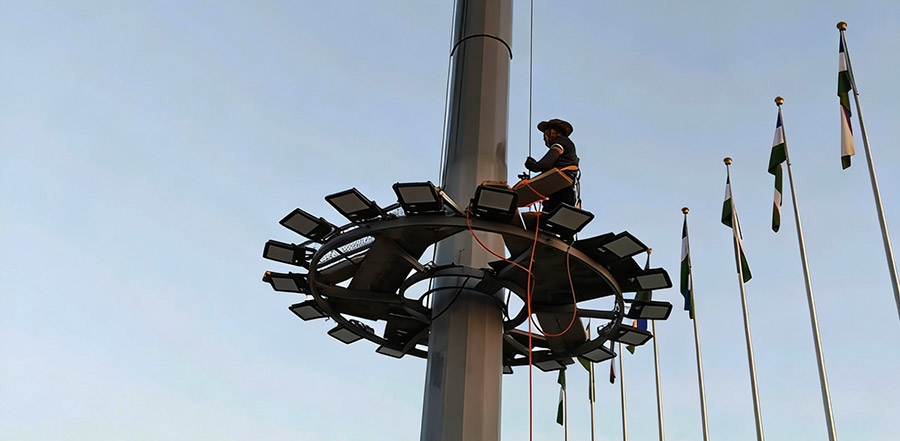

High-mast equipment access is part of the maintenance plan; the image does not establish a particular project specification.
High mast specification schedule
Use a type mark for each configuration. The schedule should connect the proposed mast to its drawings and equipment, so that a changed headframe or attachment is reviewed against the same design basis.
| Specification field | What to define | Confirmation document |
|---|---|---|
| Mast height and reference | State height above finished ground and equipment mounting levels. | General arrangement and project layout |
| Shaft sections and joints | List segment lengths, section profile, overlap or joint detail. | Approved fabrication and erection drawings |
| Steel and wall schedule | Identify grade, section sizes, thicknesses and tolerances for the proposed mast. | Structural design and material schedule |
| Headframe and equipment | Show positions, mounting interfaces, equipment mass and projected areas. | Equipment schedule and connection drawings |
| Fixed or lowering arrangement | Define access method, moving assembly, restraints and operating equipment. | Matched assembly drawings and operating documentation |
| Base and anchors | Coordinate bolt pattern, orientation, base plate and foundation interface. | Base drawing, reactions and site foundation design |
| Cable route and access | Show cable entry, access opening, earthing and electrical interfaces. | Coordinated structural and electrical drawings |
| Protective finish | Specify surface preparation, coating system and inspection requirements. | Project finish specification and inspection plan |
| Approval and delivery records | List drawings, calculations, inspections and handover documents included. | Agreed submittal and supply schedule |
How the mast interfaces fit together
Joint / overlap detail
Cable route and service opening
Concept diagram, not to scale. It identifies specification interfaces rather than a supplied mast or an erection sequence. A lowering system needs its own matched mechanical and electrical details.
Fixed headframe or lowering ring: what changes in the RFQ?
A fixed headframe stays at its mounting position; agree how the equipment will be reached for service. A lowering ring brings its supported equipment to a defined service position using a matched operating and restraint arrangement. Do not assume that a photographed ring, winch or wire rope establishes the capacity of a complete system.
- Maintenance access: define access equipment and site restrictions for a fixed headframe; define the lowering path, service position and clear working area for a lowering ring.
- Supply boundary: identify headframe, connections and access provisions; for a lowering system also list the moving assembly, operating equipment, cables and specified restraints.
- Approval documents: request drawings and equipment loads for either option; a lowering assembly also needs its matched operating, inspection and maintenance documents.
Use the high mast assembly supply schedule to identify the proposed package and exclusions.
1. Start with the area and the lighting task
Describe what people and vehicles need to see, where tasks take place, which areas must remain clear, and when lighting is used. A port apron, logistics yard, road interchange, and large parking area can have different viewing directions, obstructions, operating schedules, and limits on spill light. Mark the actual boundaries and important work zones on a plan rather than specifying a high mast by height alone.
Record existing poles and luminaires if this is a replacement or retrofit. Note access restrictions, nearby roads or properties, trees and structures, existing supply and control arrangements, and any known maintenance constraints. These details help the designer identify what must be checked before a layout is accepted.
2. Separate lighting, structural, and service requirements
A high mast package combines several disciplines. Ask the project designer to state the governing criteria and design assumptions for each one. Do not transfer a value from another site or a supplier’s generic table without confirming that it applies to the project.
| Review area | What the project team should define | What to request for review |
|---|---|---|
| Lighting task | Area boundary, activities, operating periods, target criteria and any limits on spill or glare | Project lighting calculation, luminaire schedule, layout and stated assumptions |
| Pole and support | Site conditions, loading basis, pole locations, access and interfaces with civil works | Project-specific structural calculations, drawings, foundation/interface information and design responsibility |
| Luminaires and optics | Required distribution, aiming needs, environment, electrical supply and control intent | Exact proposed model, photometric file, data sheet and configuration matching the calculation |
| Operation and maintenance | How the equipment will be inspected, isolated, accessed and serviced | Maintenance method, access requirements, operating instructions and spare-parts information |
| Approvals and delivery | Applicable local requirements, submittal stages, inspection points and handover documents | Compliance matrix, approved drawings, inspection records and manuals required by the contract |
3. Check that the photometric design matches the proposed equipment
For a meaningful comparison, the lighting calculation should use the exact luminaire model and optical distribution being offered, together with the project layout and agreed design assumptions. Confirm that the submitted photometric file identifies the same model and revision as the quotation and datasheet. If a model, optic, mounting arrangement, aiming direction, or pole position changes, ask whether the calculation must be updated.
Review the calculation’s boundary, calculation plane, included obstructions, maintenance assumptions, and reported criteria with the project’s lighting designer. Ask the responsible designer to explain any areas that are outside the calculation boundary or any assumptions that materially affect the result. Do not compare headline wattage or lumen output alone: those figures do not show how light is distributed across the actual task area.
4. Review pole, foundation, and equipment interfaces together
The pole schedule and structural submittal should identify the proposed configuration and show how the pole connects to the project’s foundation and electrical arrangement. The project engineer must establish the applicable loading criteria, site exposure, soil information, anchor details, and required design checks. The supplier should state what information it used and which party is responsible for each calculation and interface.
Check that the luminaire support or lowering arrangement, where included, is described consistently across drawings, equipment schedules, operating instructions, and maintenance documents. Verify access clearances and the planned work area with the site team. Product photographs alone are not evidence of the internal arrangement, capacity, certification, or suitability for a particular site.
5. Make the RFQ comparison like-for-like

Illustrative container-yard lighting context; no site-specific performance claim is made.
Ask each bidder to answer the same questions and identify exceptions. A low equipment price is difficult to compare if one proposal excludes design documents, controls, interfaces, commissioning support, or maintenance information that another includes.
| RFQ item | Bidder response to request | Buyer’s comparison check |
|---|---|---|
| Scope | List included equipment, engineering documents, accessories and exclusions | Are all bidders pricing the same boundary and interfaces? |
| Lighting evidence | Identify model, optic, photometric file revision and calculation assumptions | Does the calculation correspond to the exact offered configuration? |
| Structural basis | State design criteria, required site inputs and calculation/document responsibilities | Are assumptions and missing inputs visible for engineering review? |
| Controls and commissioning | Describe control interfaces, testing responsibilities and acceptance records | Are control behavior and completion evidence defined by the project? |
| Service | Explain inspection access, maintenance method, manuals and proposed spares information | Can the owner plan safe routine service and future replacement? |
| Exceptions | List deviations from the RFQ and identify alternatives separately | Have technical and commercial departures been evaluated explicitly? |
6. Use a practical submittal and acceptance sequence
- Before quotation: issue the site plan, task areas, known constraints, required criteria, and submittal list.
- At technical review: match the equipment schedule, photometric file, calculation, structural basis, and interface drawings.
- Before manufacture or dispatch: resolve comments and record the approved model/configuration and inspection requirements.
- At commissioning and handover: follow the project-approved test and aiming procedure; retain the results, settings, manuals, and unresolved-item list.
The project’s responsible engineers and authorities determine the applicable criteria and acceptance method. This checklist helps organize the evidence; it does not declare that a design complies with a particular standard.
Frequently asked questions
What information should I send for a high mast lighting quotation?
Send a site plan with the area to be lit, pole locations if known, task areas, operating requirements, supply and control information, site constraints, applicable project criteria, and the documents required for approval. If some inputs are not yet available, list them as open items rather than assuming values.
Is there a standard high mast pole height or number of lights?
No single value applies to every project. Height, luminaire quantity, optics, aiming and structural design depend on the site layout, lighting criteria, equipment configuration, and engineering checks.
Can two supplier quotations be compared by wattage and price?
Not reliably on those two items alone. Compare the exact luminaire and optic, calculation basis, pole and foundation scope, controls, interfaces, approvals, commissioning responsibilities, and service information.
What is a photometric file used for?
It describes a luminaire’s light-distribution data for use in lighting calculations. The file should correspond to the exact proposed product and optical configuration; the project designer uses it with the site layout and agreed assumptions.
Does this guide certify that a proposed system meets a standard?
No. The project specification, applicable authority, and responsible design professionals determine the criteria and compliance evidence. Request project-specific calculations and documents for review.
