Budget the complete street-lighting project against an agreed lighting service and supply scope. A luminaire unit price does not include every pole, foundation, electrical connection, installation activity or future service visit. Compare alternatives using the same site, maintained lighting requirement, operating schedule and cost period.
This guide helps project buyers organise equipment, construction and operating allowances before requesting comparable proposals. It provides a budget framework, rather than a market price list or a forecast of savings for an unidentified site.

Double-arm street lighting along a road.
Start with the road or area layout, lighting criteria, mounting locations, maintenance assumptions and nightly programme. An option that runs fewer hours or provides a different maintained result is a different service. Record the difference before comparing its cost.
Identify whether the project is a new installation, a luminaire retrofit on retained poles, a pole replacement or a stand-alone solar system. Existing feeders, foundations and supports can only be treated as reusable after the responsible team checks their condition and compatibility. A quotation should identify the design revision and quantities it covers.
| Budget item | Evidence needed for an allowance | Responsibility to identify |
| Luminaires and controls | Offered models, optics, input power, programme, quantities and included accessories | Equipment supplier and lighting designer |
| Poles, arms and supports | Approved geometry, loads, finish, mounting interfaces and supplied components | Pole supplier and responsible designer |
| Foundations and anchors | Site investigation, reactions, approved civil design and construction quantities | Civil designer, contractor and anchor supplier |
| Electrical supply and connections | Feeder route, connection point, protection, conduits, earthing and controls scope | Utility or electrical designer and contractor |
| Solar equipment, where selected | Panel, battery, controller, support arrangement and matched energy design | Identified system supplier and designer |
| Delivery and installation | Packed dimensions, route, handling, access equipment, closures and assembly scope | Logistics provider and installation contractor |
| Commissioning and handover | Required tests, settings, documents, training and acceptance records | Contract-designated delivery and acceptance parties |
| Operation and end-of-service work | Energy basis, access, inspection, replacement and disposal responsibilities | Asset owner and maintenance provider |
For each item, record whether it is included, excluded, supplied by another party or still open. Give every unresolved allowance an owner and an evidence date. Do not enter zero merely because a supplier has omitted an item from its equipment quotation.
Use the pole quotation comparison guide when normalising a pole offer. The pole cost-factor guide explains configuration-driven fabrication and delivery work; this page keeps those costs within the overall project boundary.
A stand-alone solar design can avoid a grid feeder to each lighting unit, but it still needs the specified internal wiring, battery and controller connections, supports, foundations, installation and maintenance access. Hybrid or networked arrangements can have additional electrical interfaces. Determine the actual topology before removing cable or connection costs from a budget.
For a grid option, confirm available supply, connection charges, metering or billing arrangements and the new electrical work. For a solar option, confirm the night programme, usable storage, seasonal charging, recovery requirement and replacement responsibilities. Site-specific evidence decides which work is needed; neither architecture is automatically cheaper over the selected period.
The solar quotation comparison guide covers matched system proposals. Keep its component and energy checks separate from the construction quantities and operating allowances recorded here.
For metered energy, calculate consumption from the electrical input at each operating stage, its duration, the applicable number of nights and the number of units. Include auxiliary loads and losses at the chosen measurement boundary without counting them twice. Apply the relevant tariff and any fixed charges separately. A utility billing schedule may use another basis, which should be stated.
Maintenance needs a task and access plan, not a universal annual amount. Identify the work, parts, personnel, travel, access equipment and traffic management included in each estimate. Support scheduled activities with the selected equipment instructions and the owner’s plan; support corrective-work scenarios with relevant records or clearly stated assumptions.

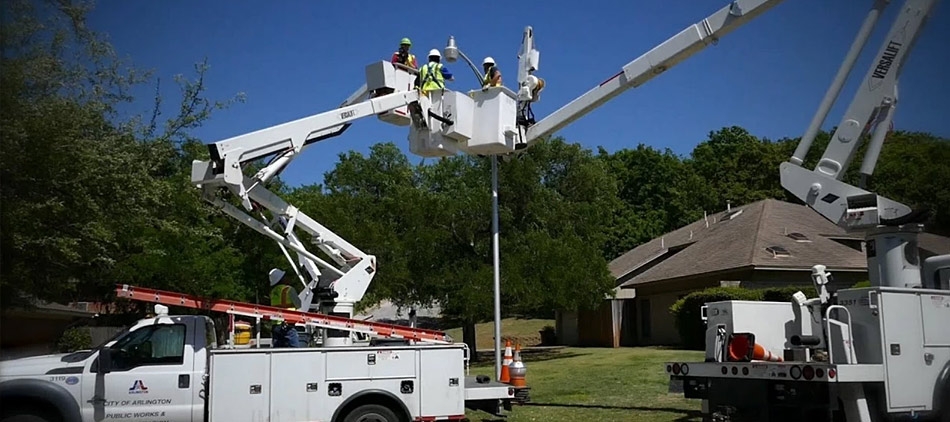

Elevated access equipment during street-light maintenance.
| Operating assumption | Basis to request | How to keep the estimate reviewable |
| Cleaning and inspection | Site exposure, accessibility and asset-owner maintenance plan | State task, interval basis and included labour/access work |
| Component replacement | Selected build, applicable performance evidence, service plan and warranty terms | Separate a planning scenario from a promised failure date |
| Corrective visits | Relevant asset records or declared scenario assumptions | Record the population, period and included work |
| Warranty support | Diagnosis, parts, freight, labour and response responsibilities | Identify which costs remain with the owner |
An LED lumen-maintenance projection is different from complete-luminaire reliability, a replacement programme or a warranty. Drivers, controls and other components have their own evidence and operating conditions. The LED lifetime and warranty guide explains those distinctions. Avoid converting a generic operating-hour value into a guaranteed calendar replacement interval.
Use the same evaluation period, currency, price date, tax basis, quantities and service assumptions. Keep initial supply and construction costs separate from energy, planned service, corrective work and later replacement. Where a formal life-cycle comparison is required, state the treatment of timing, discounting, escalation and residual value under the owner’s method.
Show sensitivity to material uncertainties such as tariffs, access requirements or replacement assumptions. A simplified total without discounting should be labelled as such. Savings or payback should only be reported for identified alternatives with traceable inputs; this framework does not establish a saving percentage or return period for every project.
Send Jieyao Lighting the site and road layout, required maintained result, nightly programme, quantities, existing infrastructure, wind and environmental inputs, proposed supply boundaries and delivery location. Identify the civil, electrical and installation work expected from other parties. Ask each response to use the same revision and list deviations and open allowances.
For equipment scope, review Jieyao’s LED street-light option, the LED street-light range and the steel-pole range. Submit the project brief through the project enquiry page so the proposed supply and document package can be identified. Final pricing and responsibilities belong in the agreed project offer and contract.
Only after its included scope is defined. Separate the luminaire or system package from civil works, electrical connections, delivery, installation and ongoing responsibilities.
No fixed ranking applies. Site access, existing infrastructure, approved design, local work rates and equipment scope determine the project allocation.
A stand-alone system changes the supply arrangement. Its actual wiring, storage, controller, supports and maintenance requirements still need to be included.
Review which diagnosis, parts, labour, freight and access costs are covered. A parts warranty does not by itself pay for every service visit.
Identify the component, service conditions, evidence, timing assumption and included work. Keep a planning scenario separate from a guaranteed service life or observed failure rate.
Compare the same technical service, included work, documented exceptions and operating assumptions before evaluating the alternatives. Unit price alone cannot determine the result.
The budget and operating tables are original procurement frameworks. They are not market-price surveys, measured failure-rate datasets or results from a completed Jieyao project.
